FY25 Water Line Replacement Project

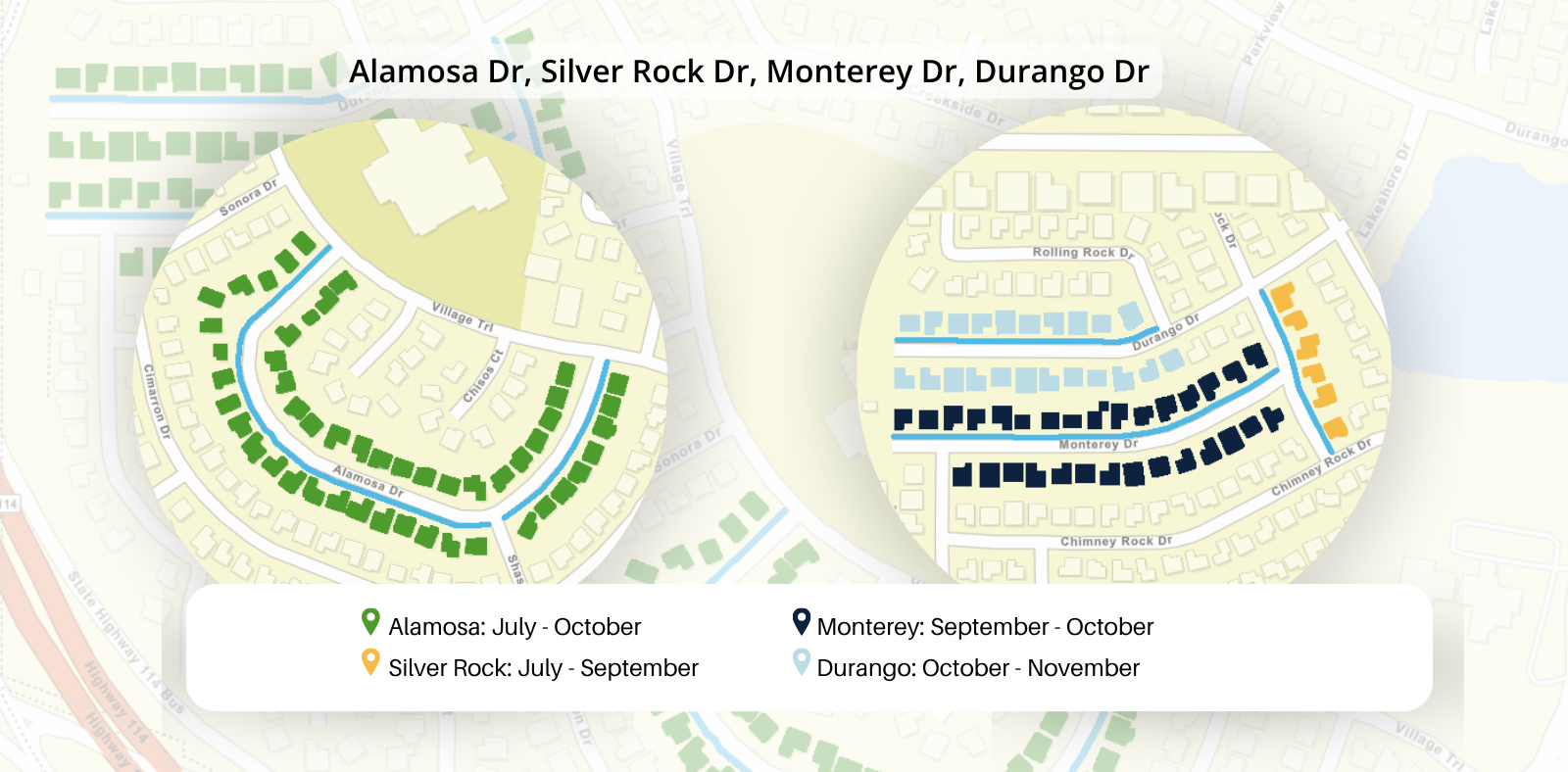

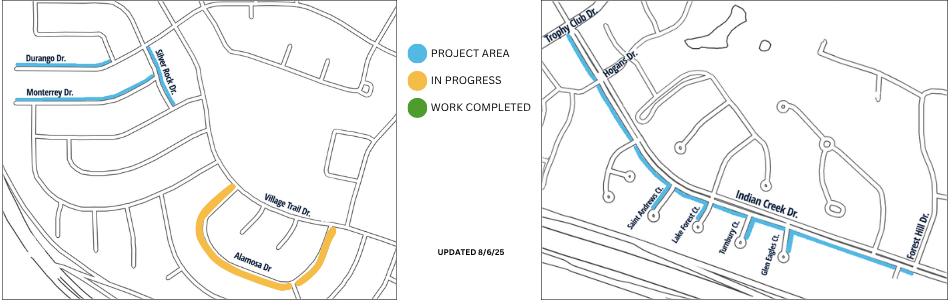

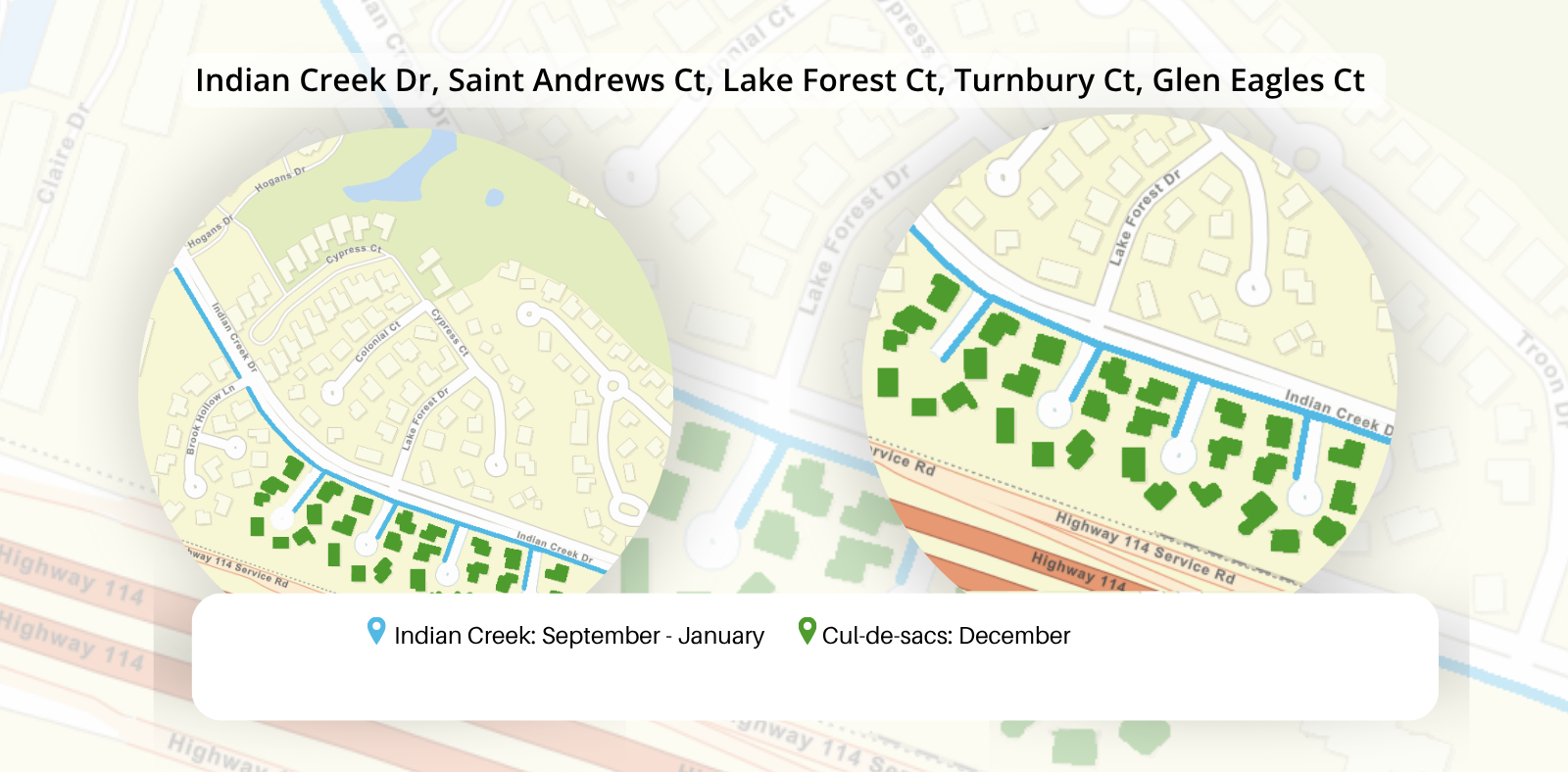

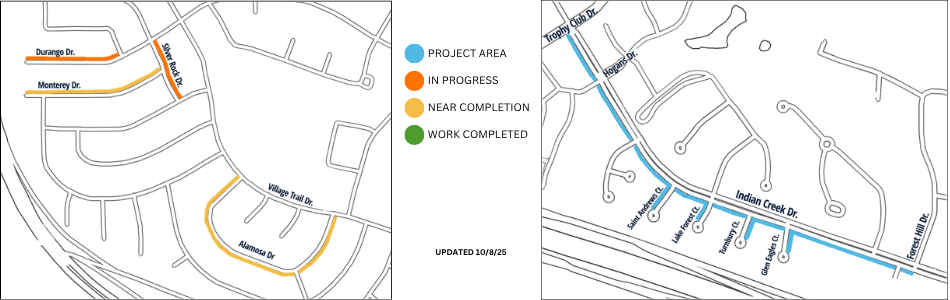

Map of project area showing Alamosa Dr under construction

SCOPE OF WORK

This water line project will replace approximately 8,500 linear feet of the existing water lines with new high pressure polyvinyl chloride (PVC) pipe. PVC is not susceptible to alkaline or acid soil conditions and can bend without breaking to accommodate minor movement in our Texas soil.

SCHEDULE

  • Construction began in early July and is expected to take approximately six months.
  • Normal work hours are Monday through Friday from 7:00 a.m. – 7:00 p.m.
  • Dates may change due to widespread rain, freezing temperatures, equipment failures, material delays or other unforeseen circumstances.

WHAT TO EXPECT

A temporary water line will be set up that will provide water to homes during construction. There will be minor interruptions to your water service when it is connected and disconnected. You will be notified 48 hours in advance of the work. You can expect minor traffic impacts, rolling shoulder closures and periodic intersection closures.

PROJECT EMAIL UPDATES

Project Fact Sheet
August 2025

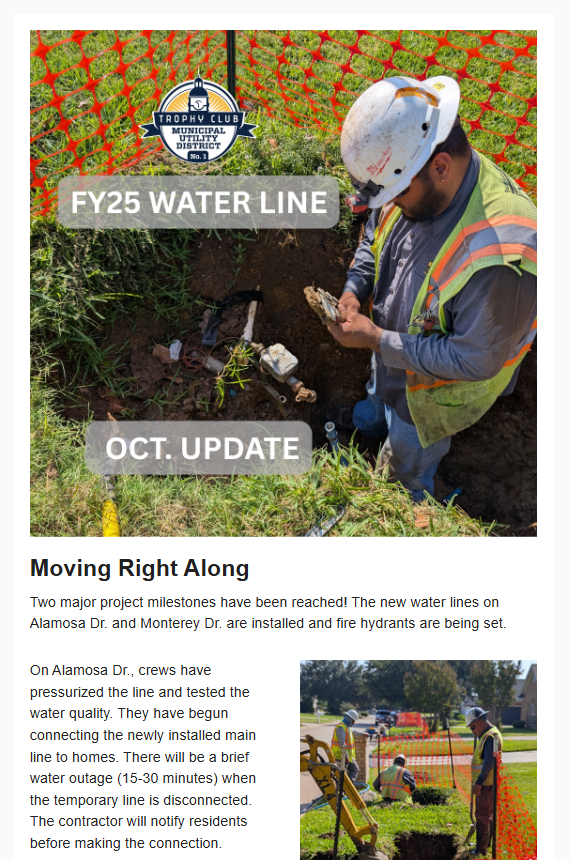

July 2025

FY 25 Water Line Replacement Fact SheetWater Line Replacement Aug. update

Water Line Replacement Kick Off

FY25 Water Line Project Fact Sheet (PDF)

Water Line Replacement - Aug. Update

Annual Water Line Replacement Kick Off

FY25 Water Line Replacement Presentation pdf

FY25 Water Line Replacement Presentation (PDF)

PROJECT CONTACTS
Luis Conchas                                        Mike McMahon
Excel 4 Construction                           Operations Manager
luis.conchas_xl4@yahoo.com           mmcmahon@tcmud.org
682-554-4740                                       682-831-4689

The District annually evaluates the water and wastewater systems to determine the remaining useful life of the pipelines and to develop a phased plan for repair and rehabilitation. This area was identified to optimize function and maintain quality service for customers.

Updated 8/6/2025
